11 Xenia Implementation Checklist: Are You Ready to Go Live?
Last updated: October 19, 2026
This article guides you through the essential steps to prepare your workspace and team for a successful launch. You'll learn how to verify settings, user roles, templates, and monitor task completion to ensure smooth operations.
Are you Ready to Go Live
What "Going Live" Means
Going live means your front-line team will start using Xenia for real — completing their assigned checklists, seeing their tasks on their devices, and having their submissions tracked in your reports.
Before that happens, spend 30 minutes running through this checklist. Catching a misconfigured role or a missing location now takes 5 minutes to fix. Catching it after 50 employees have logged in takes much longer.

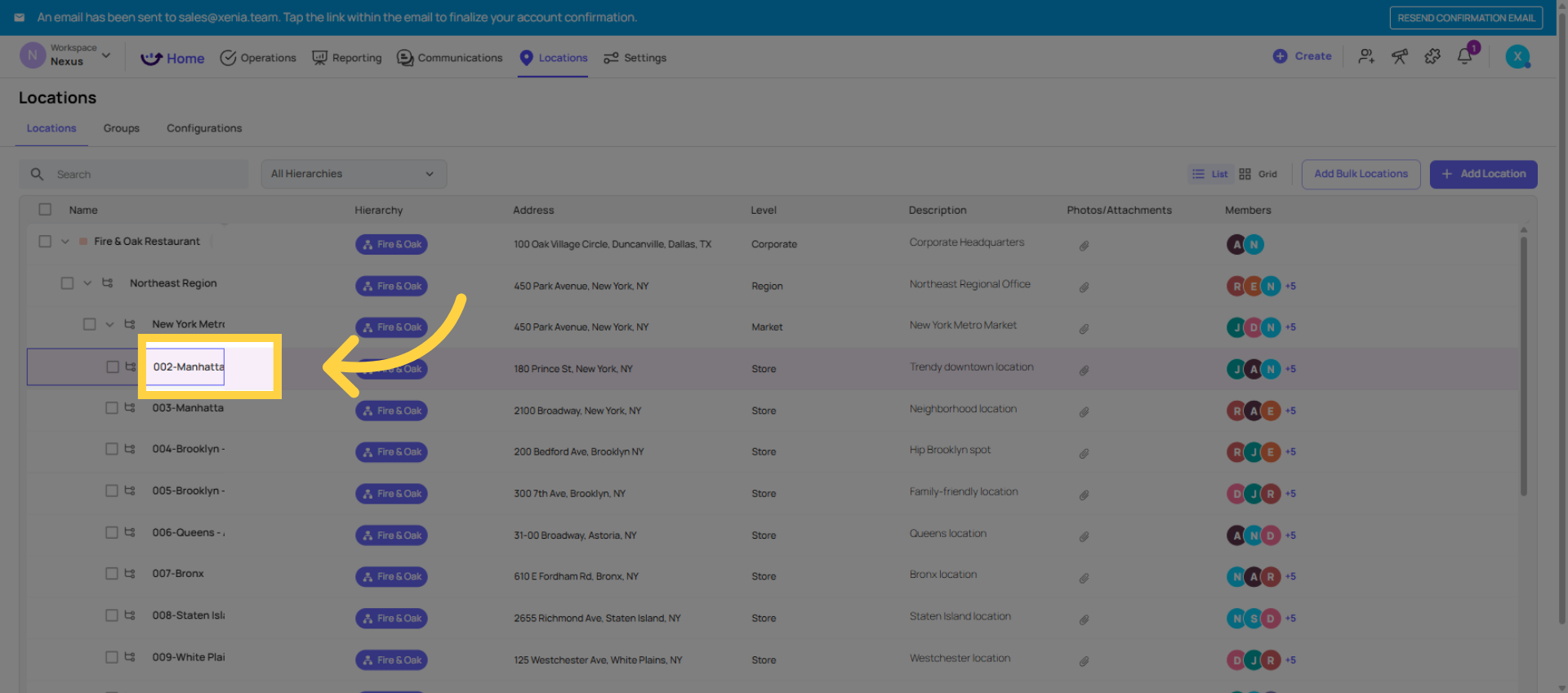

Navigate Location Tabs and Verify Sites
SECTION 1: Workspace Foundation
Location hierarchy is built — all regions, districts, and sites are added with correct parent-child nesting

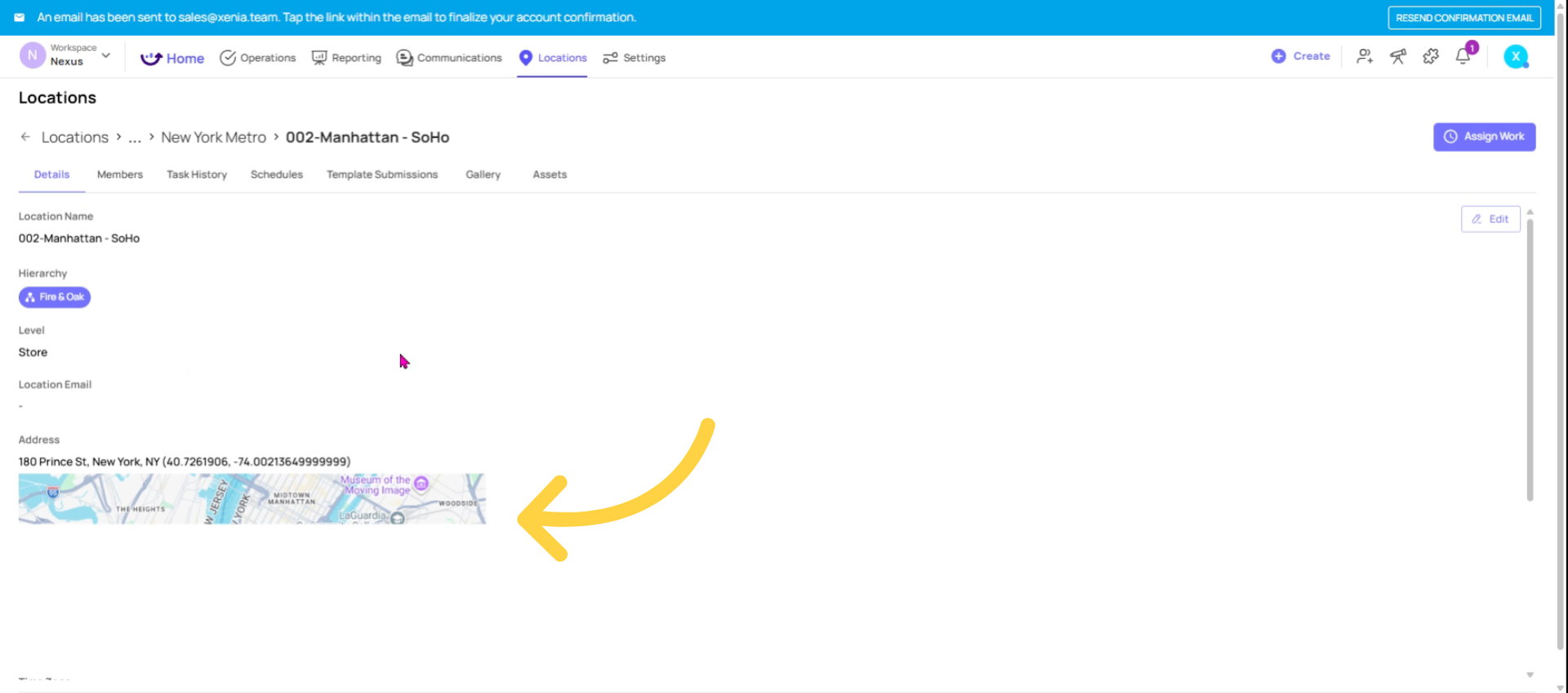

All site-level locations have addresses — required for timezone-based task scheduling
Hierarchy labels are customized — level names (e.g., "District," "Territory," "Store") reflect your org's terminology
Hierarchy structure is finalized — you've confirmed you won't need to restructure it after launch (changes cascade throughout the system)
Click the location site to review its details and ensure all information is accurate and complete.

Without an address, Xenia can't detect the time zone and your task will show up at wrong local time.

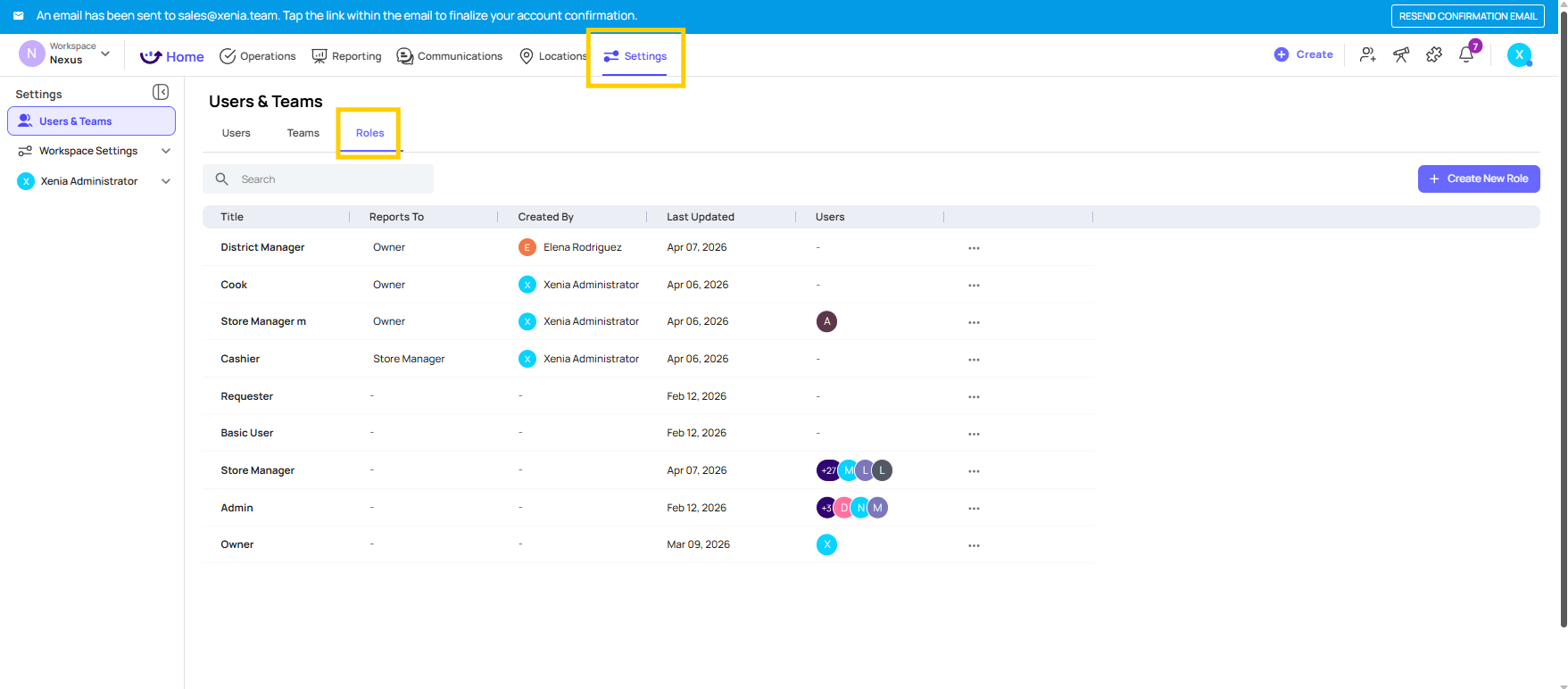

Check Roles Tab Permissions
SECTION 2: Roles & Permissions
All roles are created — one role per distinct job type (Store Manager, Cashier, District Manager, etc.)

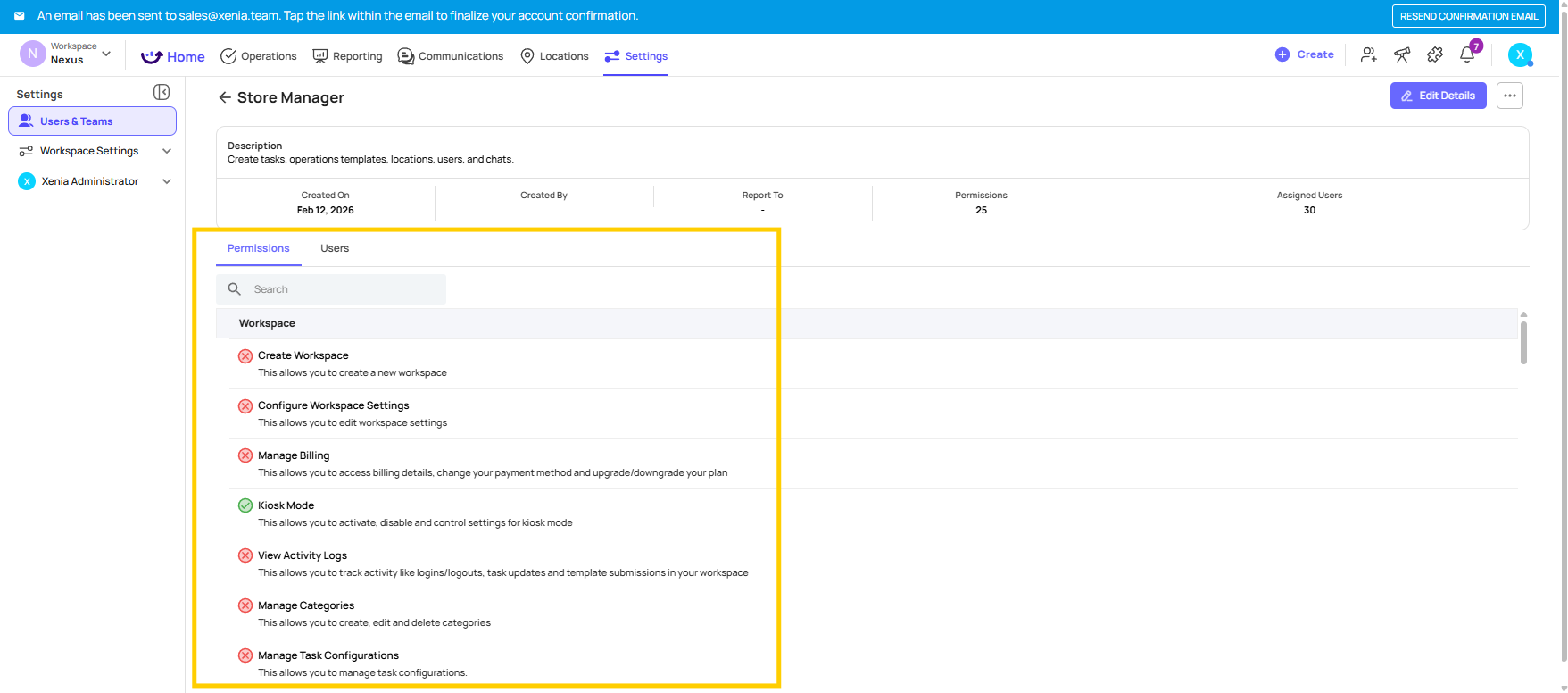

Permissions are configured for each role — especially task visibility, manage templates (should be OFF for frontline), and access controls
"Reports To" is set for each role — required for conditional notifications when tasks are overdue
Homepage layout is assigned to each role — Location Pulse for frontline/store roles; Above Store or Custom Dashboard for management
At least one Admin or Owner account is active — never go live without a fallback admin account

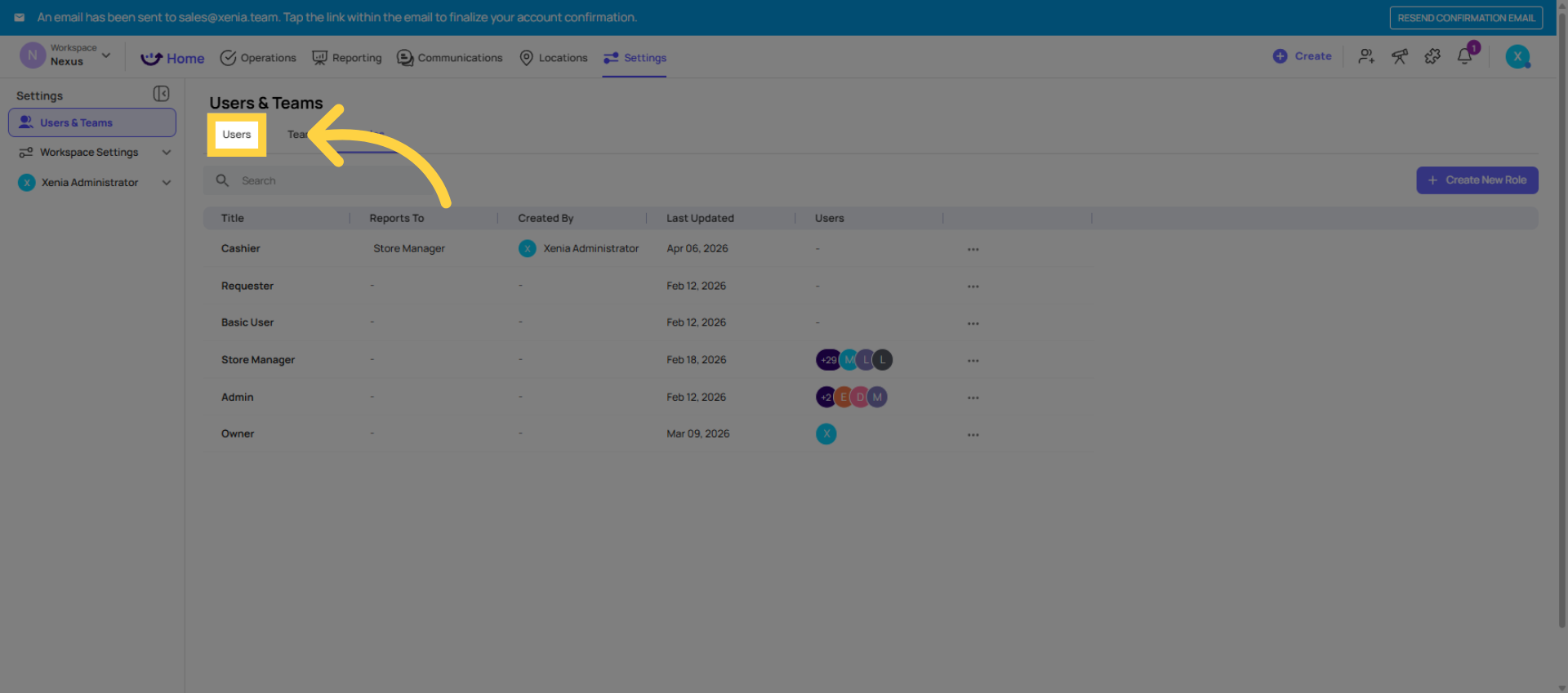

Access Users Section
SECTION 3: Users & Accounts

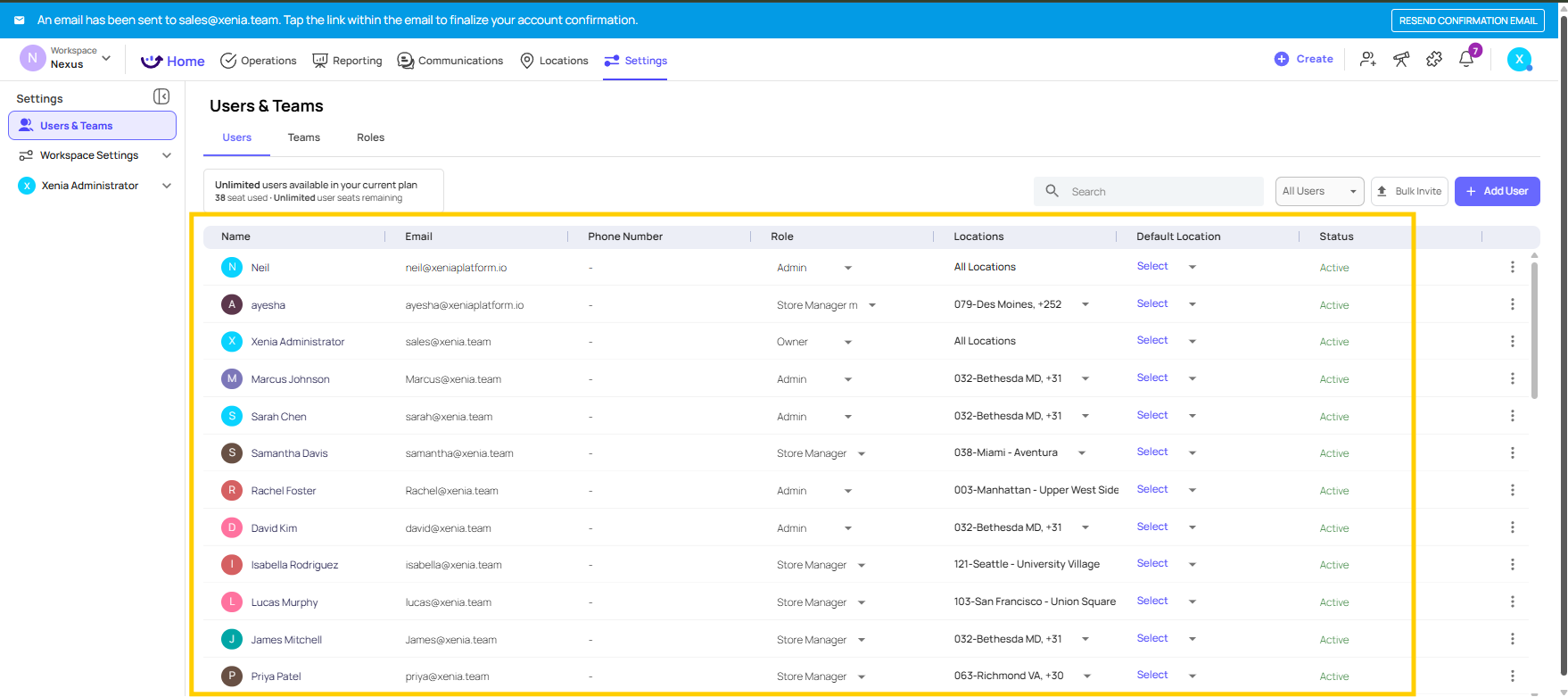

All users are invited — either individually or via CSV bulk invite
Every user has the correct role assigned — spot-check at least 5 users to confirm
Every user has at least one location assigned — no location = no data visibility, no tasks
Account strategy is decided — individual accounts for management, role-based shared accounts for frontline (if applicable)
For shared/role-based accounts: passwords are set directly (don't wait for invite emails) and tested on the actual device
All invite emails have been received and accepted — or passwords have been set by the admin
Email addresses are unique — no duplicates across the system

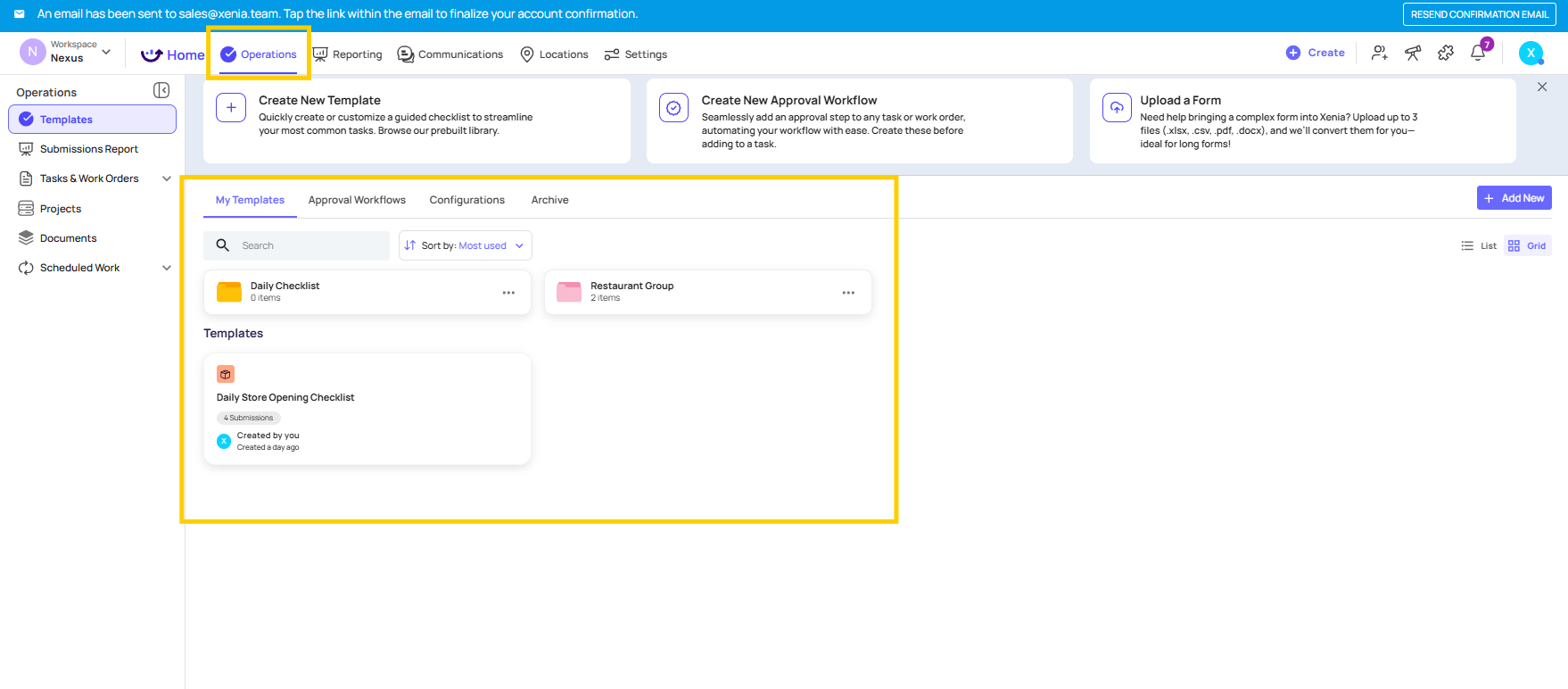

Review Checklist Template
SECTION 4: Templates (Checklists)
All checklists are built — every checklist you plan to launch on Day 1 is in the template builder
Checklists are reviewed for accuracy — questions are correct, sections make sense, step types are appropriate
Required steps are set — critical items are marked required so they can't be skipped
Photo automations are configured — conditional photo requirements are set up for key accountability steps
Manage Templates permission is OFF for frontline roles — store staff should not be able to edit your checklists
Template access controls are set — the right roles can submit; editing is restricted to admins
All templates are Published — unpublished templates won't appear for anyone

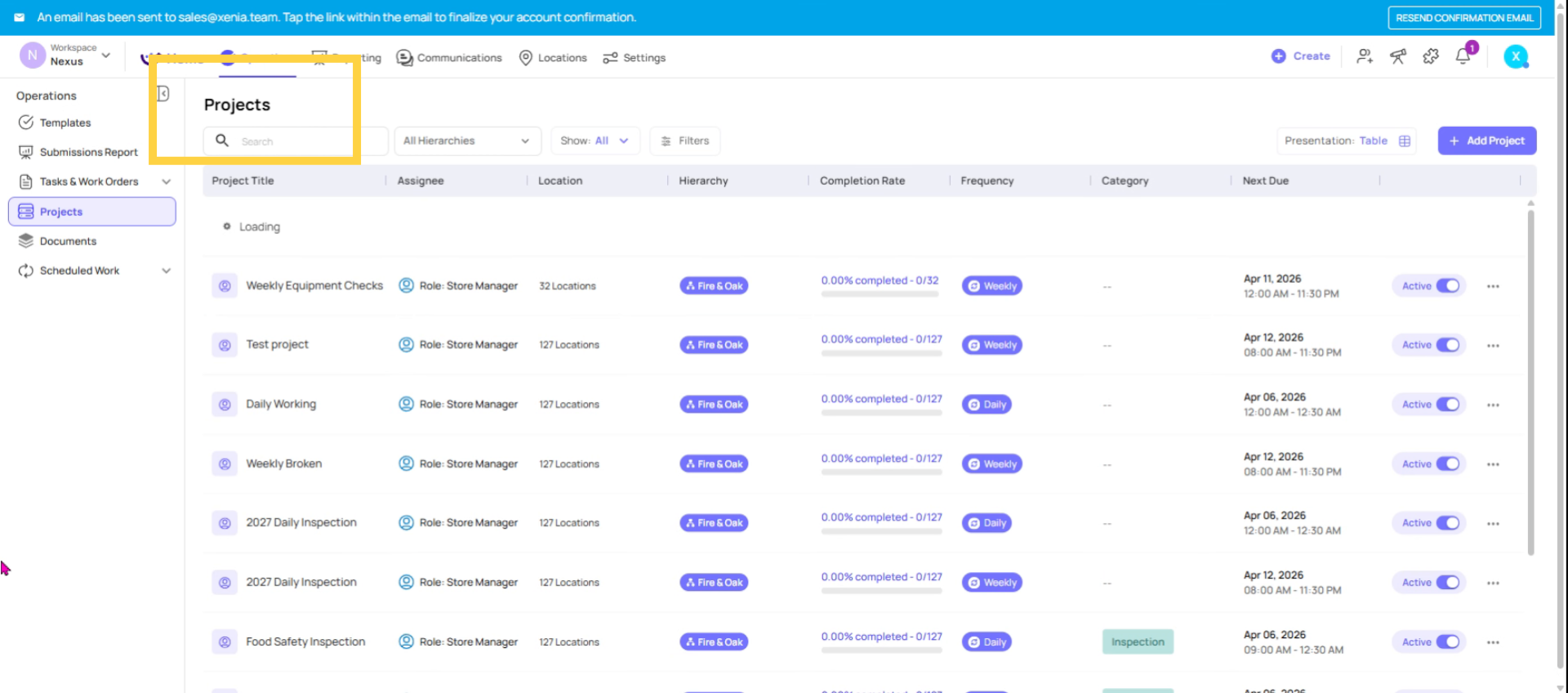

Confirm Project Settings
SECTION 5: Projects (Deployments)
At least one project is created and active — your first checklist is deployed via a role-based project
Projects are assigned to roles (not individual users) — ensures continuity when staff changes
Correct locations are selected — each project runs at the right stores
Start time and due time are configured — tasks appear at the right time for each location's timezone
Cadence is set correctly — daily, weekly, or monthly as needed
"Mark as missed after due time" is configured — intentionally turned on or off based on your policy
Overdue/missed notifications are set — the right role is notified when tasks are not completed on time

Final Implementation Advice
SECTION 6: Devices & Mobile Access
Xenia app is downloaded on all store devices — iOS or Android, search "Xenia" (purple smiley face icon)
All frontline accounts are logged in and tested — log in on the actual device that will be used in the store
Home screen layout appears correctly — Location Pulse is showing on store/frontline devices
Today's tasks are visible — after the project's start time, the checklist appears on the device
At least one test submission has been completed — someone has gone through a checklist end-to-end on the actual device
📊 SECTION 7: Reporting Sanity Check
At least one test submission appears in reports — go to Operations → Submission Reports and confirm you can see the test submission
Completion data is rolling up correctly — check that the project's completion rate shows the test submission
Location-level filtering works — filter by one location and confirm only that location's data shows
Manager/admin can see submissions from their assigned locations — log in as a manager and verify they can only see their locations' data
3. Pre-Launch Test: Do This Before Your Team's First Shift
Before going live, run a quick end-to-end test yourself:
Log in as a frontline user (use one of your store accounts) on the actual store device
Confirm the home screen — does it show Location Pulse? Are today's tasks visible?
Open a task — tap on it and click Start Checklist
Complete the checklist — go through every step, including any photo steps
Submit — tap Submit and confirm it goes through
Log back in as admin — go to Reporting and confirm the submission appears
Check the project — open the project and confirm it shows as Completed for that location
If all 7 steps work cleanly — you're ready to go live. If anything breaks, fix it now before your team encounters it on Day 1.
4. Common Issues Found During Pre-Launch Testing
Issue | Likely Cause | Fix |
Tasks not appearing on device | Project start time hasn't arrived yet, or user isn't assigned to the correct role/location | Check project timing; verify user's role and location in Settings → Users |
Wrong home screen showing | Role's homepage layout is set incorrectly | Settings → Roles → Edit → Homepage Layout → Location Pulse |
Can't submit checklist — required step blocked | A required step needs to be answered first | Complete all required steps, or adjust template if a required step is incorrect |
No data appearing in reports | Template's submission access settings may be too restrictive, or no project-linked submission yet | Check template settings, or do a test submission via a project |
User can't log in | Invite email not accepted, or password not set | Settings → Users → three dots → Send Password Instructions or Update Password |
Location not showing on device | User has no location membership | Settings → Users → Update → add the correct location |
You're Live. What's Next?
Congratulations — your workspace is set up and your team is on Xenia. Here's what to do in the first week after launch:
Day 1–3: Monitor closely
Check daily completion rates in your project reports
Watch for Missed or Overdue tasks — these indicate timing, access, or training issues
Be available to answer frontline questions about the app
Week 1: Gather feedback
Talk to your store managers — what's working, what's confusing?
Look at your first submissions — are the checklist steps clear? Are the right photos being taken?
Identify any templates that need adjustment before adding more
After Week 1: Expand
Add your next checklists (closing checklist, food temp log, etc.)
Add more projects as you're ready
Start exploring reporting dashboards to track performance trends
