Setting Relative Due Dates on Corrective Tasks

Ayesha
Ayesha
This article explains how to set relative due dates for corrective tasks created by workflows. You will learn how to choose appropriate due date windows to match task urgency and ensure timely completion.

1. What a Relative Due Date Is

When a workflow fires and creates a corrective task, a relative due date sets how much time the assignee has to complete the task — measured from the moment the task is created, not from a fixed calendar date.

The clock starts at task creation, which happens at the moment of submission when the workflow trigger fires.

Example: A workflow fires at 10:00am when a temperature reading is out of range. The corrective task is created at 10:00am. A relative due date of "4 hours" means the task is due at 2:00pm.

If no relative due date is configured, the task has no deadline. It appears in the task board without a due date, won't trigger overdue notifications, won't show as overdue or missed in reporting, and may sit unresolved indefinitely. For any issue with a meaningful resolution expectation, always set a relative due date.

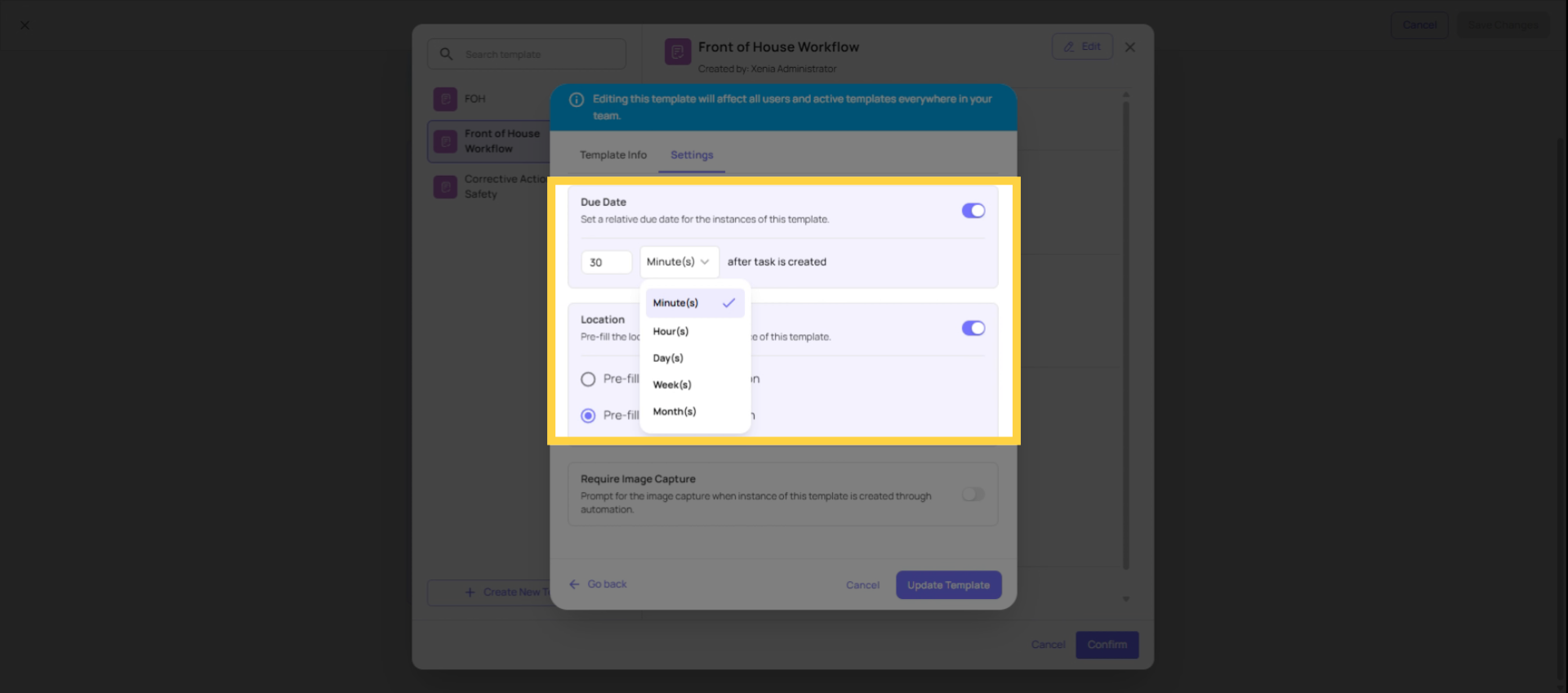

2. The Available Time Units

Relative due dates can be set in:

Minutes — Due time is calculated precisely from the moment of task creation. A 30-minute due date created at 10:15am means the task is due at 10:45am. Use for urgent safety or operational issues that must be resolved within the same shift.

Hours — Due time is calculated precisely from task creation. 4 hours from 10:00am = 2:00pm. Most common for same-day operational issues where the resolution window is measured in working hours.

Days — Due time is set to 11:59pm on the day the due date falls. A 2-day relative due date created on Tuesday results in a due time of 11:59pm on Thursday — giving the full two calendar days regardless of what time on Tuesday the task was created. Use for issues that need attention within a few business days but not necessarily within hours.

Weeks — Due time is 11:59pm at the end of the week count. A 1-week due date gives until 11:59pm seven calendar days from creation. Use for non-urgent maintenance or follow-up tasks.

Months — Due time is 11:59pm at the end of the month count. Use for periodic review tasks or long-cycle compliance actions.

Important note on Days/Weeks/Months: Because these are set to 11:59pm on the target day, a task created at 9:00am with a 1-day due date is due at 11:59pm that same calendar day — not 24 hours later. If you need a precise 24-hour window, use 24 hours rather than 1 day.

3. Setup Relative Due Date

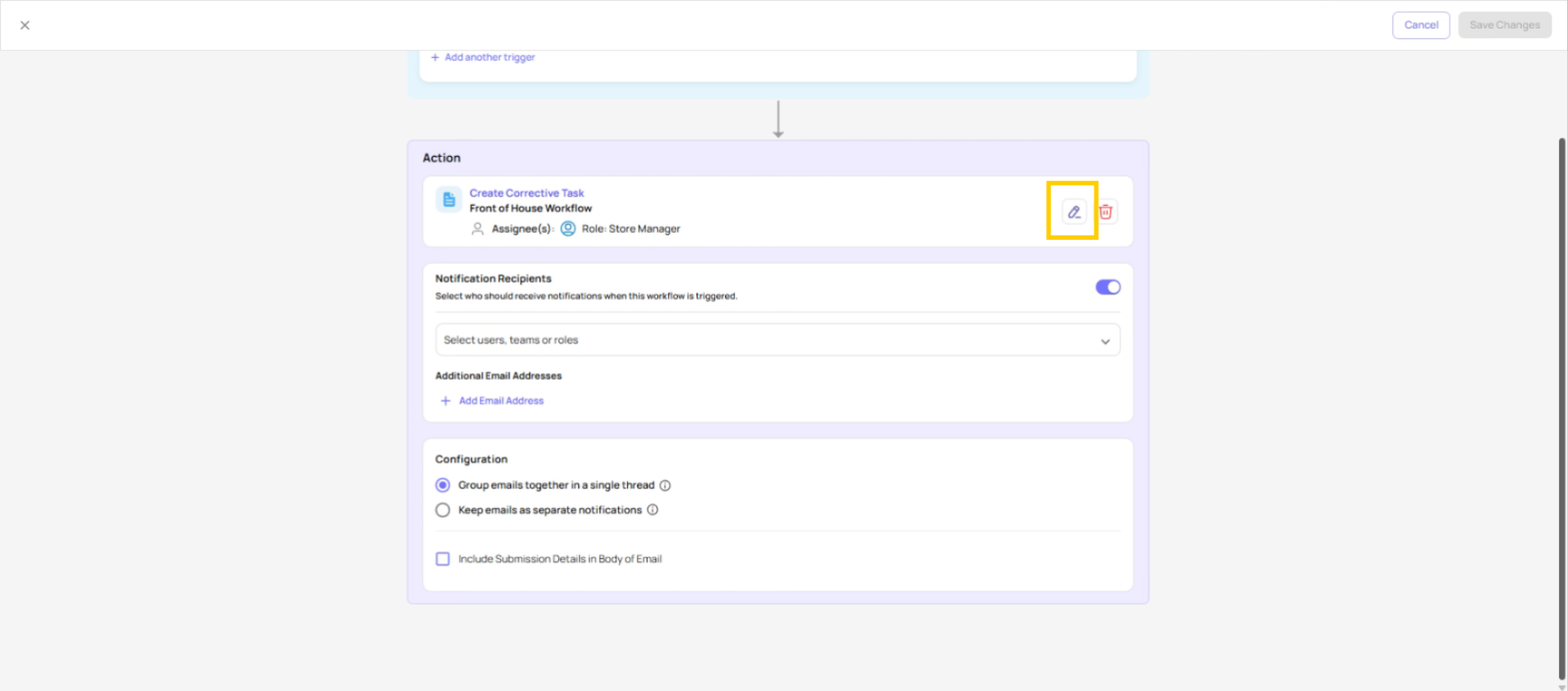

In order to set the due date, click on the pencil option here to edit the template. Now click on Edit again. Once you click on Edit, click on Next.

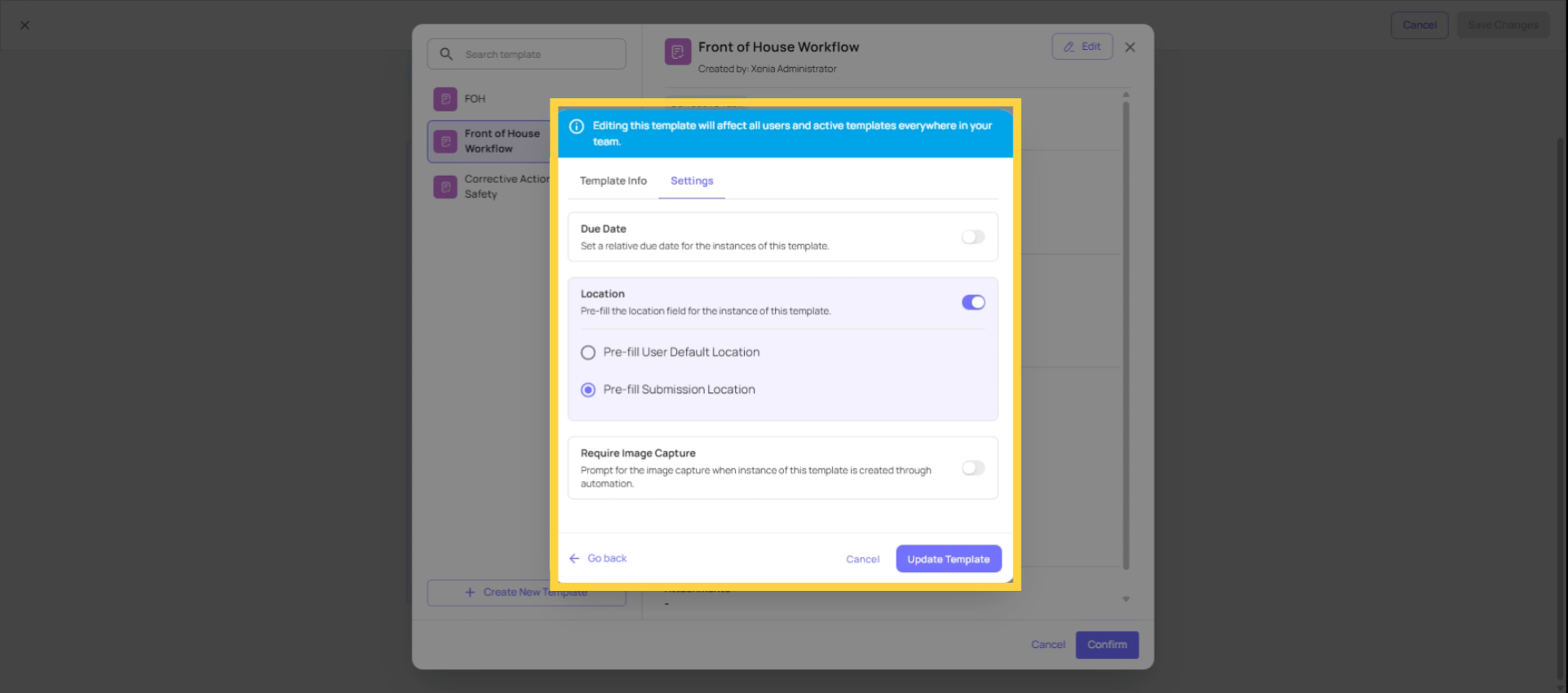

Click on Settings. You will see the Due Date option here to set a relative due date for the instances of this template. Match the window to the real urgency of the issue.

Match Due Date to Urgency

Don't default everything to 24 hours. The due date signals to the team how urgent this actually is. A four-hour due date says this needs to be handled now. A three-day due date says get it to this week.

Interpret Due Date Urgency Signals

Choosing the Right Window

The right relative due date reflects the real operational urgency of the issue — not a default or a wish. A window that's too short creates pressure on the receiving team for issues that genuinely take time. A window that's too long provides no meaningful accountability.

Issue TypeSuggested WindowRationale
Food safety temperature violation1–4 hoursMust be resolved within the same service period
Robbery or security emergency15–30 minutesImmediate escalation required
Equipment outage affecting service2–4 hoursNeeds resolution before impacting guests
Vendor delivery problem24 hoursSame-day resolution expected, allows scheduling
Non-urgent maintenance request2–3 daysCan be scheduled, not an immediate blocker
Monthly compliance follow-up1–2 weeksLong cycle, allows proper scheduling
This article explains how to set and manage relative due dates for corrective tasks to ensure timely resolution based on urgency. For more information, see related articles on task management and workflow configuration.
